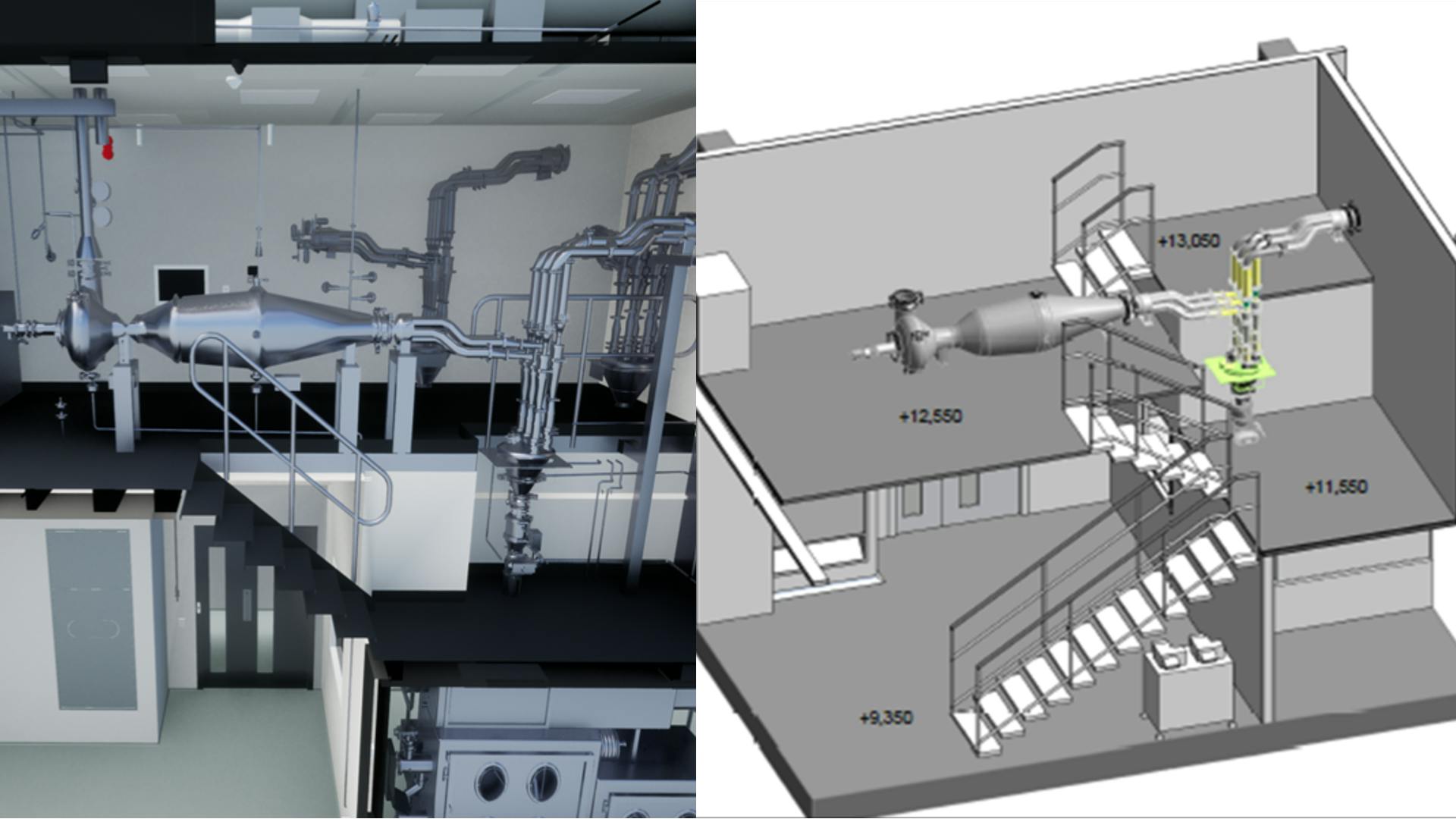

Spray drying with organic solvents at scale introduces serious explosion hazards that are not always present during lab testing. Designing equipment and facilities to manage these risks safely requires more than minor upgrades. It often calls for major capital investments in fire and explosion suppression and nitrogen inerting systems, as well as accurate electrical classification and division design for the drying chamber and associated areas, sealed conduits, controlled access, and strict adherence to regulatory standards and operating procedures. Overlooking these factors in the early design phase can lead to hidden costs, late-stage redesigns, and permitting delays that can push product launch back by six to twelve months, with direct impact on revenue and market competitiveness.
3. Fragmented procurement can lead to costly specification gaps
One recent example of a foreseeable delay involved a secondary dryer purchased for final drying of a spray-dried product. The factory built the dryer to the explosion-proof design specification and conducted a witnessed factory acceptance test (FAT). After installation in a Class I, Division 2 room adjacent to the spray dryer, a third party executing the site acceptance test (SAT) discovered that the electrical components within the secondary dryer control cabinet were not rated for Class I, Division 2 service. This caused a significant startup delay that could have been prevented by rigorous equipment specifications and a thorough review of submittals.
4. Treating containment as an afterthought can trigger cascading delays
When working with high-potency active pharmaceutical ingredients (APIs), containment must be a core component of pharmaceutical facility design, not a late-stage add-on. Retrofitting equipment with split butterfly valves (SBVs), upgrading material dispensing stations to include isolators, adding floor drains for contained process waste, or finding space for additional gowning and airlocks in an existing spray drying operation is not only expensive but often impractical because of space, airflow, and compliance constraints. Mid-project retrofits can trigger cascading delays, budget overruns, and increased regulatory scrutiny. Designing for containment and hazard control from the outset is significantly more cost-effective and supports operator safety, regulatory compliance, and smoother project execution.
5. Ignoring operational friction and cleaning validation can cause excessive downtime
